Project details
Project Details |
Information |
Project Name: |
Upgrading from Gravel to Bituminous Standard of Tirinyi-Pallisa-Kumi Road Project |
Funding Agency: |
Government of Uganda (GoU) and Islamic Development Bank |
Contractor: |
The Arab Contractors (Osman Ahmed Osman & Co) |
Supervision Consultant: |
Construction and Supervision Unit -UNRA |
Implementing Agency: |
Uganda National Roads Authority |
Contract duration: |
36 Months |
Contract sum: |
274,124,619,957.01 |
Commencement date: |
15th March 2018 |
Expected completion date: |
15th March 2021 |
Overall physical progress: |
27.00% against 29.35% |
Overall time progress: |
534 days (48.79%) |
Financial progress: |
33.73% against 34.65% (as extracted from S-Curve August 2019) |
Project progress

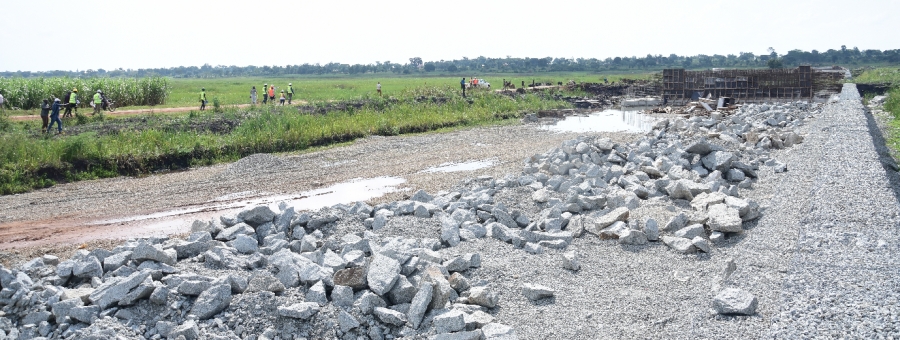

The contractor is undertaking earthworks from CH 19+630-CH 55+500, mostly doing clearing and grubbing, removal of topsoil, roadbed preparation, common excavation swamp improvement, fills, subgrade and sub-base processing. Swamp treatment, gabion and culvert construction at km 41+000-41+980 and km15+100-15+900 is ongoing. Subgrade, subbase and base layer construction is also ongoing from Km 24+780-Km 41+000 with exception of seasonal swamps. The contractor has also started the construction of the Asphalt layer after doing a trial from km35+050 to km 35+100.
